ISO 50001 Energy Management: Implementation, Monitoring & Compliance
A manufacturing-focused guide to ISO 50001 energy management. Learn how to build an energy baseline, define EnPIs, identify significant energy uses, and automate monitoring and compliance with Proxus.
Energy is now a strategic variable in manufacturing. With rising utility prices, tightening emissions rules, and pressure from customers to disclose carbon intensity, factories are moving from ad‑hoc savings projects to formal energy management systems.
ISO 50001 is the global standard that provides that system. This post explains what ISO 50001 requires, how to implement it in an industrial plant, and how to automate compliance using real‑time data.
What is ISO 50001?
ISO 50001 is an international standard for establishing, maintaining, and improving an Energy Management System (EnMS). Its goal is continuous improvement in energy performance — not a one‑time audit pass.
The standard follows a Plan‑Do‑Check‑Act cycle:
- Plan — policy, baseline, objectives, note Significant Energy Uses (SEUs)
- Do — implement action plans and operational controls
- Check — monitor, measure, and analyze energy performance
- Act — correct, improve, and update the system
For the official overview, see ISO’s public summary.²
Why manufacturers adopt ISO 50001
Typical drivers:
- Energy cost = 20–40% of production cost in many processes (cement, metals, chemicals, cold chain).
- Regulatory alignment with EU ETS, national carbon reporting, and incentive programs.
- Customer requirements for Scope 1–2 disclosure and product carbon footprints.
- Operational discipline: a repeatable way to find and sustain savings.
Plants commonly see 5–15% reduction in energy intensity within the first year when measurement is automated and SEUs are actively managed.
Core ISO 50001 requirements (practical view)
1. Energy policy and leadership commitment
You need a formal policy signed by leadership, with defined roles and responsibilities.
2. Energy review
You must understand how energy is consumed:
- Identify energy sources (electricity, gas, steam, compressed air).
- Map consumption by area, line, and major equipment.
- Detect drivers (production volume, product mix, ambient temperature).
3. Energy baseline
A baseline is your “starting point” — the reference against which improvement is measured.
Baselines can be:
- Absolute (kWh/month)
- Normalized (kWh/ton, kWh/unit)
- Mode‑specific (startup vs steady‑state)
4. Energy performance indicators (EnPIs)
EnPIs translate energy into performance measures, such as:
- kWh per ton of product
- kWh per operating hour
- kWh per batch
- kWh per OEE point (advanced plants)
5. Significant Energy Uses (SEUs)
SEUs are the processes/equipment that materially impact your energy performance. ISO expects you to:
- Define SEU criteria
- Prioritize improvement
- Monitor SEUs continuously
6. Monitoring, measurement, and analysis
This is where most plants fail. Manual meter reads and monthly reports do not qualify as “systematic monitoring.” You need:
- Reliable sub‑metering on SEUs
- Consistent timestamping
- Context (line state, batch state, downtime)
- Data retention for audits

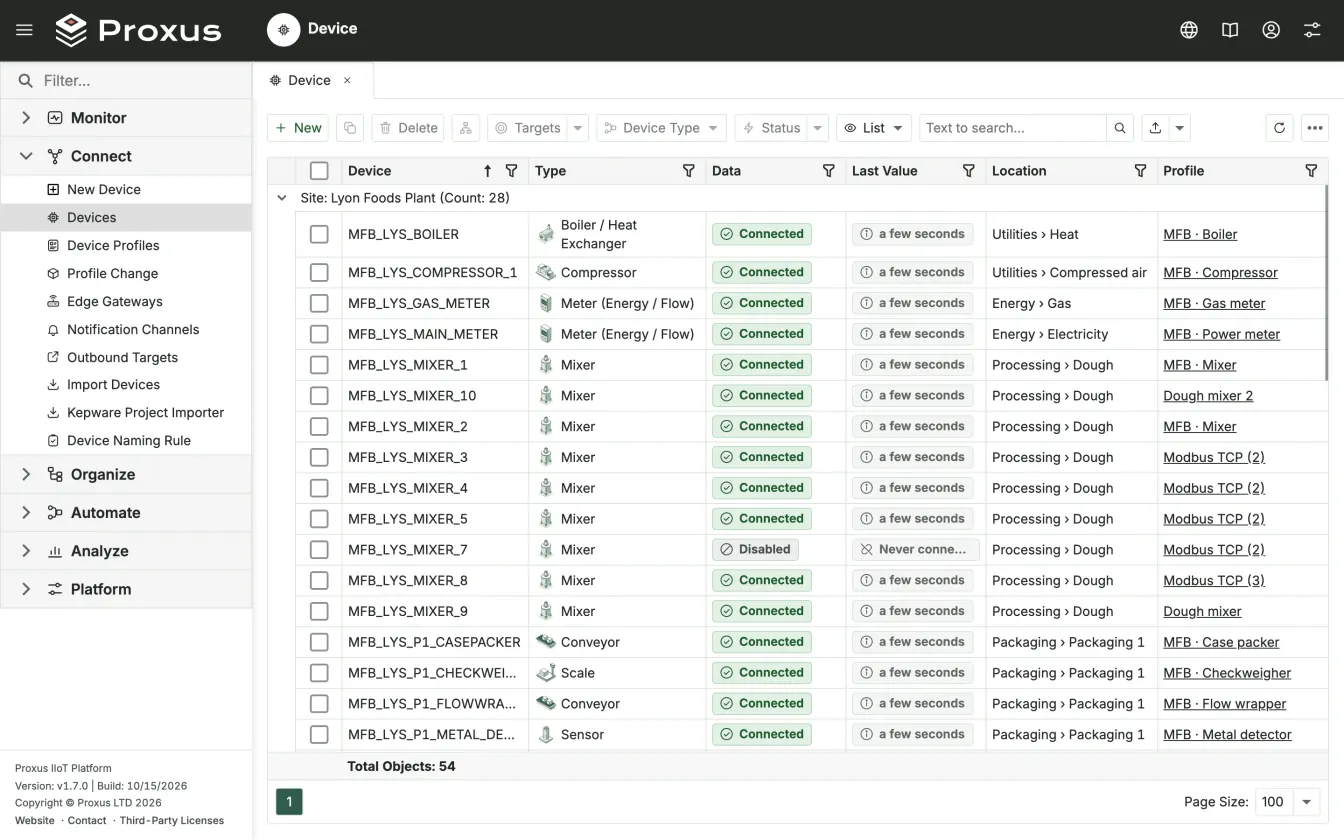

Proxus provides this monitoring layer in Energy solutions and Dashboards.
Building a manufacturing energy baseline (step by step)
Step 1 — Choose the scope and window
Pick a stable historical period (3–12 months). If your process is seasonal, include a full cycle.
Step 2 — Collect consumption and production context
At minimum:
- Energy consumption per source (kWh, Nm³, ton steam).
- Production output in the same period.
- Operating hours / line state.
Step 3 — Normalize
Example baseline for a packaging line:
- Electricity: 2,500,000 kWh/year
- Output: 12,500 tons/year
Baseline EnPI = 2,500,000 / 12,500 = 200 kWh/tonIf product mix changes, you may need multiple EnPIs per product family.
Step 4 — Document assumptions
Auditors will ask:
- Why this window?
- What factors were excluded?
- How do you adjust for production shifts?
Having all data in a single namespace with clear metadata makes this defensible. See UNS.
Identifying SEUs with Pareto logic
In manufacturing, SEUs typically include:
- Compressed air systems
- Large motors and drives
- Process heating/cooling
- Pumps and fans
- Refrigeration (food and cold chain)
A simple SEU identification workflow:
- Sub‑meter the top 10 consumers.
- Rank by energy share.
- Select the top contributors (often 70–80% of energy).
- Define operational controls + EnPIs for each.
With Proxus, SEU detection can be automated by aggregating energy topics and correlating with machine states at the edge. See Edge Computing.
Monitoring and control in real time
ISO 50001 expects monitoring to drive action, not just reporting.
What “good” monitoring looks like
- Live consumption by SEU (kW, kWh)
- Trend vs baseline EnPI
- Correlation with production state
- Alerts when intensity drifts
- Automatic weekly/monthly audit exports
Example: rule‑based anomaly alerts
You can define alerts such as:
- “Compressor kW above baseline by 15% for 30 minutes.”
- “Line is stopped but energy draw remains high.”
- “Peak demand exceeds contracted limit.”
Proxus enables this through an edge‑side rules engine. See Rule Engine and Rule Engine docs.
Metering architecture for ISO 50001
ISO does not prescribe a specific topology, but auditors will look for traceable, reliable data.
A practical metering layout for manufacturing:
- Main incomer meters per utility (electricity, gas, steam).
- Area meters per workshop or building.
- SEU sub‑meters on the top consumers (compressed air, chillers, ovens, large drives).
Proxus connects these meters via common protocols (Modbus, OPC UA, IEC 104, DLMS, BACnet) and publishes them into a unified hierarchy. This ensures every meter has:
- A stable path (site/area/equipment)
- Units and scaling metadata
- A consistent timestamp source
See Connectivity and the Architecture overview.
Measurement & Verification (M&V) in practice
When you implement an efficiency project, you need to prove savings.
Example project: replacing a compressor controller.
- Baseline window: 8 weeks before change.
- Post‑change window: 8 weeks after change.
- Normalize by operating hours and production volume.
- Report EnPI delta with confidence bounds.
With automated data retention, you can reproduce the evidence for surveillance audits without manual spreadsheet work.
Peak demand and cost control
Many factories pay for peak demand (kW) as much as for energy (kWh). ISO 50001 allows EnPIs like:
- Peak kW per shift
- Peak kW per ton
Edge‑side rules can:
- Alert when demand approaches contract limits.
- Shed non‑critical loads during peaks.
- Correlate peaks with line states to remove waste (e.g., idle ovens).
This closes the loop between monitoring and operational control.
Audit and certification workflow
Typical certification flow for a plant:
- Gap analysis (internal or consultant)
- Implementation (policy, baseline, SEUs, EnPIs, monitoring)
- Internal audit + management review
- Stage 1 audit (documentation review)
- Stage 2 audit (on‑site verification)
- Certification + surveillance audits annually
Real‑time monitoring shortens the “Check” phase dramatically, because evidence is already structured and searchable.
A short ISO 50001 readiness checklist
Before your Stage 1 audit, verify:
- Energy policy signed and roles assigned.
- Full energy review completed and documented.
- Baseline EnPIs defined and normalized.
- SEUs identified with clear criteria.
- Sub‑metering installed on SEUs.
- Monitoring dashboards live and traceable.
- Alerts and corrective actions defined.
- Evidence retention and exports tested.
If you need a template walkthrough, our team can provide a plant‑specific checklist during onboarding.
Common pitfalls
- Baseline without normalization. Production changes make the baseline meaningless.
- Too few meters. You can’t manage what you can’t measure.
- No link to operations. Energy data without line state hides root causes.
- Manual evidence collection. Audits become a fire drill.
- SEUs defined once, never revisited. They must evolve with the plant.
How Proxus supports ISO 50001
Proxus acts as the measurement and automation backbone for industrial EnMS:
- Connectivity to power meters, PLCs, and SCADA via standard protocols.
- Unified Namespace so every SEU has a consistent path and metadata.
- Edge execution for low‑latency intensity alerts even during outages.
- Dashboards and reporting for auditors and management.
- Integrations to cloud, BI, or ESG reporting tools.
Start from the Energy solution page and Connectivity platform.
FAQ
Do I need ISO 50001 if I already track energy?
If tracking is ad‑hoc, ISO 50001 adds structure: baseline logic, EnPIs, SEUs, and continuous improvement cycles. Many plants discover hidden savings once data is normalized and contextualized.
How granular should monitoring be?
For SEUs: at least 15‑minute resolution is typical; high‑variability equipment may need 1‑minute or sub‑minute sampling. Edge buffering prevents data overload.
Can I certify one plant without the whole group?
Yes. ISO 50001 supports site‑level certification. A Unified Namespace model also makes multi‑site roll‑up easy later.
Conclusion
ISO 50001 is not about passing an audit — it is about running energy like any other manufacturing asset. The faster you can measure, contextualize, and react, the faster energy intensity drops.
If you want to build a data‑driven EnMS across your lines, explore Energy solutions or contact us.
² ISO public summary: https://www.iso.org/iso-50001-energy-management.html
